212 MW
planned generation capacity of the Lincoln Gap Wind Farm with Battery Storage, located approximately 15 km to the west of Port Augusta in South Australia. Additional battery storage of 10 MW.
800 GWh
of electricity will be generated each year.
155,000
approximate number of households that can be powered by the farm each year.
600,000 tonnes
estimated reduction in GHG emissions once the farm is operational.

?
hectares of land will be used. The farm will be connected to a 275kV grid line managed by ElectraNet.
59
Senvion turbines will be used.
3
major organisations involved: 1) Project owner and developer: Nexif Energy 2) EPC & O&M: Senvion 3) Power distribution: ERM Power.
$450 million
estimated project cost. The project is owned by Nexif Energy and funded by the Denham Capital and the Clean Energy Finance Corp.
100
peak jobs during construction phase.
10
permanent jobs during operational phase.
2017
Planned start of construction early part of the year with completion likely in 2019.
May 2017
LGC contracts with ERM Power signed
Sep 2017
EPC contract with Senvion signed
Sep 2017
Transmission Connection Agreement with ElectraNet signed
Oct 2017
Power Purchase Agreement signed with ERM Power.
12 Nov 2017
Financial Close achieved. The Clean Energy Finance Corporation (CEFC) will act as financier, lending up to $150 million for construction of the first stage of the wind farm and Investec has provided facilities totalling $39 million for working capital and letters of credit.

23 Jan 2018
Ground breaking/SOD ceremony held at the site.
Sep 2018
Delivery of turbine components to site begins.
Oct 2018
35 turbines under construction.

11 Oct 2018

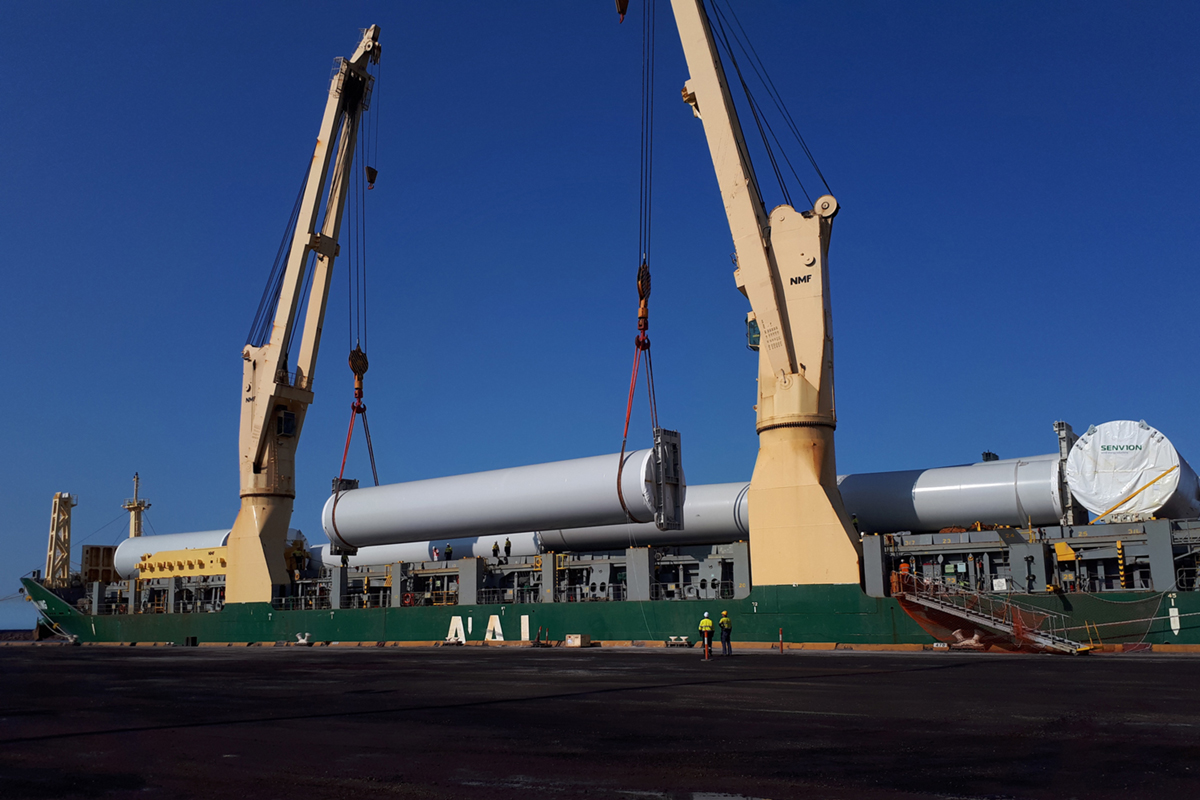

Senvion turbine blades from Germany and Vietnam arrive at the Whyalla Port.
09 Nov 2018
Fluence - a Siemens/AES joint venture - has been signed up to deliver a 10MW/10MWh battery based energy storage system, targeted for completion in May 2019. According to a joint statement, the project will utilise Fluence’s industrial-grade Advancion energy storage platform to provide improved Fast Frequency Response (FFR) capabilities, helping the project to meet new interconnection requirements for renewable generation projects in South Australia.
24 Feb 2019
Nexif Energy announces successful “energisation” of the project’s major sub-station and associated network infrastructure. This will enable the project to begin commissioning the first of the wind farm’s 59 Senvion turbines by August.
Apr 2019
Construction workers at face an uncertain future after Senvion entered administration to deal with its financing troubles.
28 Apr 2019
Nexif Energy announces it has proactively negotiated with Senvion and made successful arrangements to ensure continued progress on the Lincoln Gap Wind Farm while Senvion addresses its financial difficulties and requirements.
28 Apr 2019
3 turbines are completely operational and have started feeding power into the grid.
