75 MW
planned installed capacity of Wirsol's Clermont Solar Farm, located in Rockhampton, Northern Queensland.
205 GWh
of electricity will be generated per year.
30,996
approximate number of households that can be powered by the farm each year.
107,118 tonnes
estimated reduction in CO2 emissions each year, once the farm is operational.

192.6
hectares of land will be used for the solar farm.
?
Risen solar modules will be mounted on NEXTracker mounting system.
3
major organisations involved: Project Developer: Wirsol, EPC and O&M: RCR Tomlinson Ltd, PPA: Simec Zen, Merchant mode.
?
project cost.
?
peak jobs during construction phase.
?
FTE during operational phase.
1Q 2018
Planned commencement of installation with completion expected by 3Q2018.
14 Nov 2017
Diversified engineering and infrastructure company, RCR Tomlinson Ltd announces that it has been selected as the Preferred EPC Contractor for two major contracts, totalling approximately $260 million for the Engineering, Procurement and Construction (“EPC”) and Operation and Maintenance (“O&M”) for the 75 MW Clermont Solar Farm and the 88 MW Wemen Solar Farm.
15 Dec 2017
CEFC announced it had committed $97 million in senior secured debt that would enable WIRSOL to begin construction on the project as early as January 2018, before having secured a Power Purchase Agreement (PPA) for the solar output.
18 Dec 2017
Wirsol today announced that it had reached financial close for the construction farm. The project will be financed on a fully merchant basis with a long-term debt facility from the Clean Energy Finance Corporation (CEFC) and equity provided from WIRSOL’s parent WIRCON, headquartered in Germany.
Jan 2018
Design commences.
Feb 2018
Mobilization and construction commences.
Mar 2018
Piling commences.
Apr 2018
Tracker installation commences.
21 Jun 2018
8 year power offtake agreement signed with Simec Zen for a majority of the farm's output, while the rest will be sold in merchant mode.

15 Jul 2018

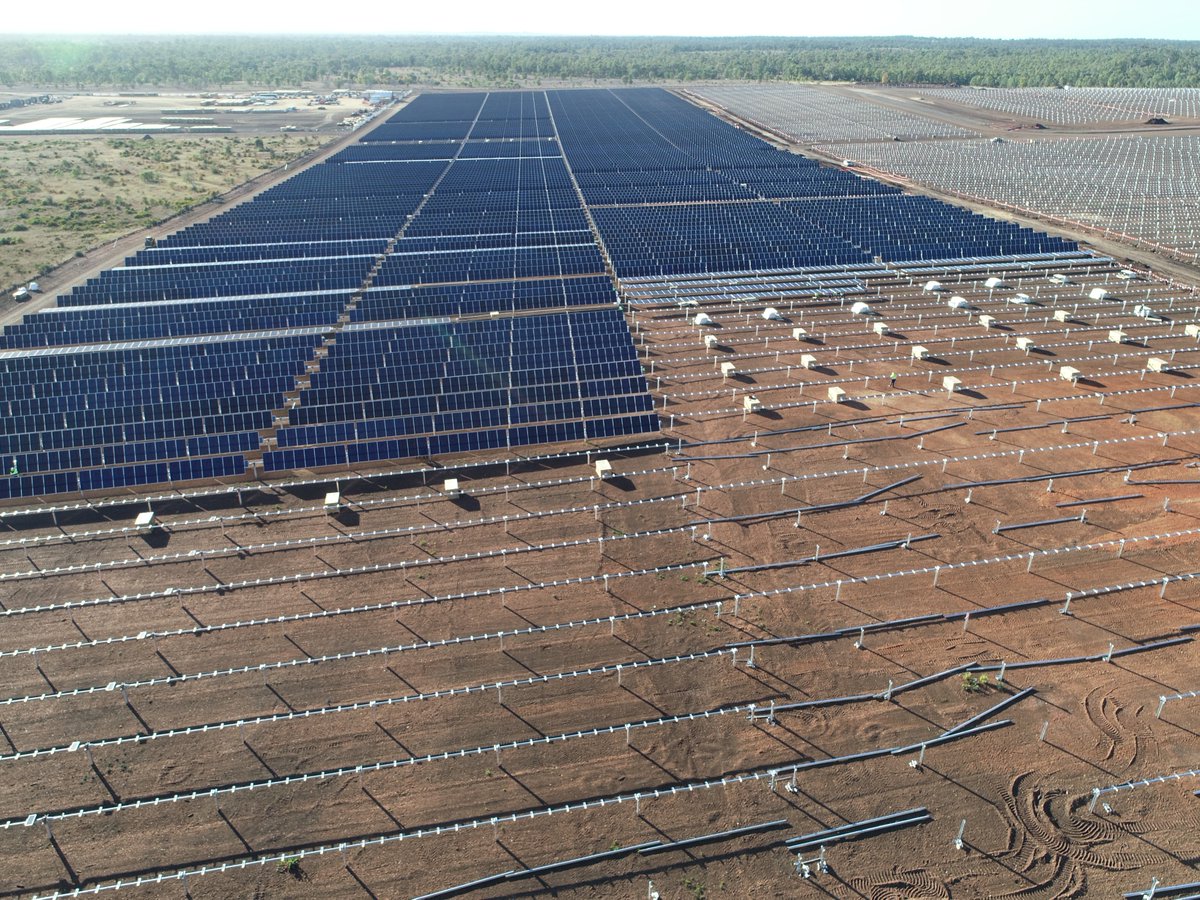

Module installation commences.
19 Aug 2018
A generation authority application submitted to the Department of Natural Resources, Mines and Energy, Queensland.

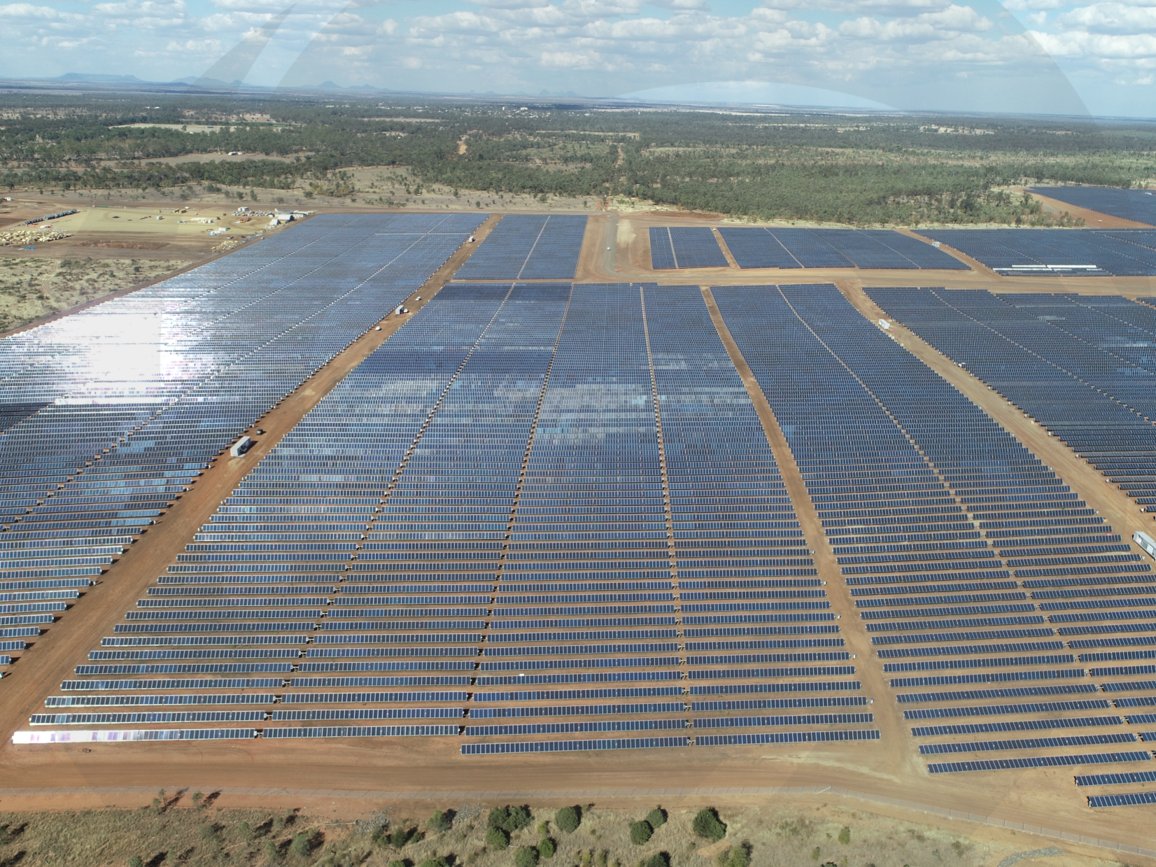

Sep 2018
Module installation nearing completion.
