Lilyvale Solar Farm, Queensland, Australia - Project details and construction updates

Lilyvale Solar Farm, Queensland, Australia - Project details and construction updates Last Modified: 06-Aug-2020 6:36 AM
  • 100 MW
    generation capacity of FRV's Lilyvale Solar Farm located around 50 km North-East of Emerald, in Central Queensland.
  • ? GWh
    proposed to be generated per year.
  • 45,000
    approximate number of households that can be powered by the farm each year.
  • 175,000 tonnes
    estimated reduction in CO2 emissions each year, once the farm is operational.

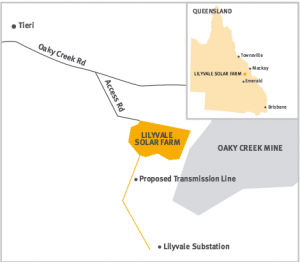

  • hectares of rural land will be used for the farm. The solar farm will be connected to the electricity network via the existing Lilyvale substation.
    396
    hectares of rural land will be used for the farm. The solar farm will be connected to the electricity network via the existing Lilyvale substation.
  • photovoltaic modules with single-axis tracking systems will be used and 25 transformer centres constructed.
    379,260
    photovoltaic modules with single-axis tracking systems will be used and 25 transformer centres constructed.
  • 4
    major organisations involved: Project Developer: Fotowatio Renewable Ventures (FRV), EPC and O&M: Acciona and Gransolar , Distribution: Ergon Energy.
  • $120 million
    estimated project cost
  • 200
    peak jobs during construction phase.
  • 5
    FTE during operational phase.
  • 3Q2017
    Proposed start of construction with 12 - 18 months required for completion.
  • Sep 2015
    Project received development approval.
  • 07 Feb 2017
    12 year PPA signed with Ergon Energy.
  • 28 Sep 2017
    Fotowatio Renewable Ventures reaches financial close. Financing was closed with the Australia and New Zealand Banking Group (ANZ), The Bank of Tokyo-Mitsubishi UFJ (MUFG) and the Sumitomo Mitsui Banking Corporation (SMBC).
  • 05 Oct 2017
    A joint venture between Gransolar (GRS) and ACCIONA Industrial awarded turnkey EPC contract.
  • 15 Aug 2018
    A generation authority application submitted to the Department of Natural Resources, Mines and Energy, Queensland.

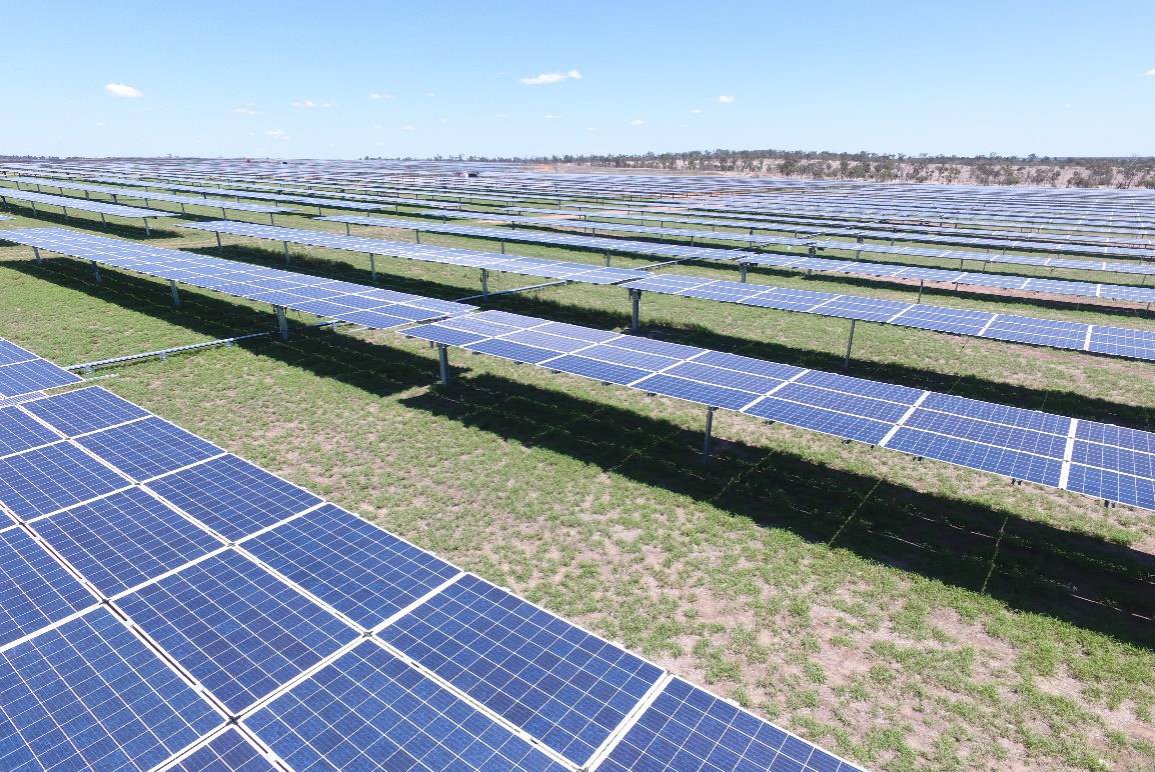

  • Ergon announces construction is nearing completion.
    Oct 2018
    Ergon announces construction is nearing completion.

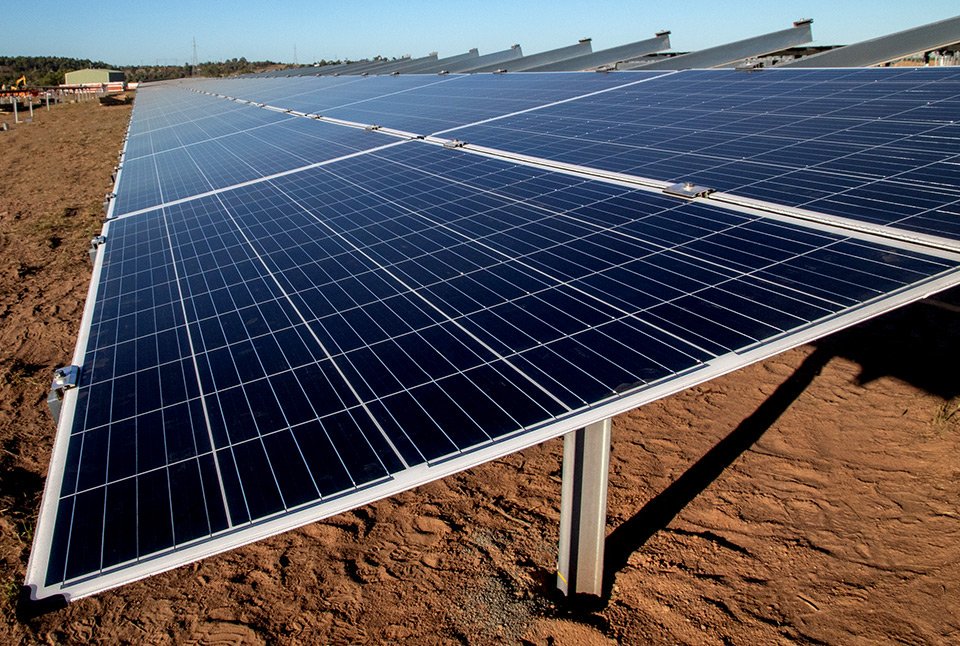

  • ISE Ingenia reports they are working on the commissioning of the project after conducting the detailed engineering, technical assistance during construction and as-built documentation.
    30 Nov 2018
    ISE Ingenia reports they are working on the commissioning of the project after conducting the detailed engineering, technical assistance during construction and as-built documentation.

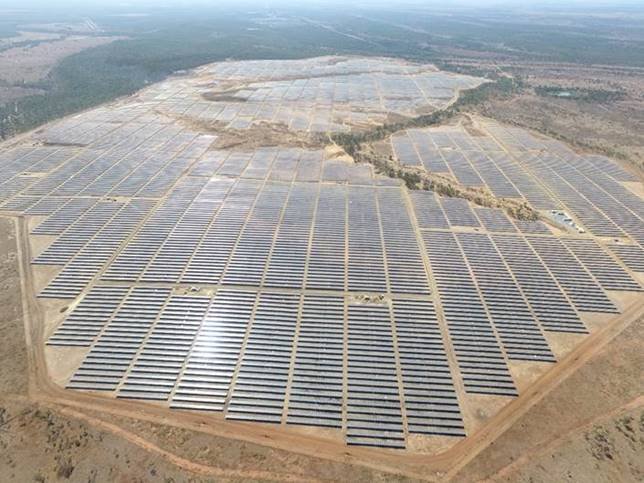

  • Project joins the grid and begins production.
    12 Mar 2019
    Project joins the grid and begins production.
